Single-Ply Roofing Installation Process Single-ply roofing installation isn't a weekend DIY project. Getting a leak-free, wind-resistant roof means precision seaming, correct flashing, and choosing the right attachment method for your building. Miss any of these, and you're looking at seam failures, wind uplift damage, and voided warranties.

Single-ply systems (TPO, PVC, EPDM) are simpler to install than old-school multi-ply built-up roofing. But "simpler" doesn't mean "easy." This work belongs to trained industrial roofing crews, not general handypersons.

Poor installation shows up later, not immediately. Seams part. Wind gets under a corner and starts peeling membrane back. Warranty claims get denied because documentation is missing. This guide walks through the full installation process, from substrate prep to seam validation, following manufacturer and industry best practices.

TL;DR

  • Process covers prep, attachment choice, membrane layout, seam welding, and flashing details
  • Match attachment to substrate and wind zone: mechanical, fully adhered, induction-welded, or ballasted
  • Test seams and T-joints before close-out—they fail more often than field membrane
  • Temperature and humidity during install directly affect weld and adhesive quality
  • Pros lock in code compliance, correct insulation R-values, and warranty eligibility

Single-Ply Roofing Installation Process Overview

Single-ply installation follows a defined sequence:

  1. Substrate preparation
  2. Attachment method selection
  3. Membrane placement
  4. Seaming and welding
  5. Flashing and detail work
  6. Inspection and validation

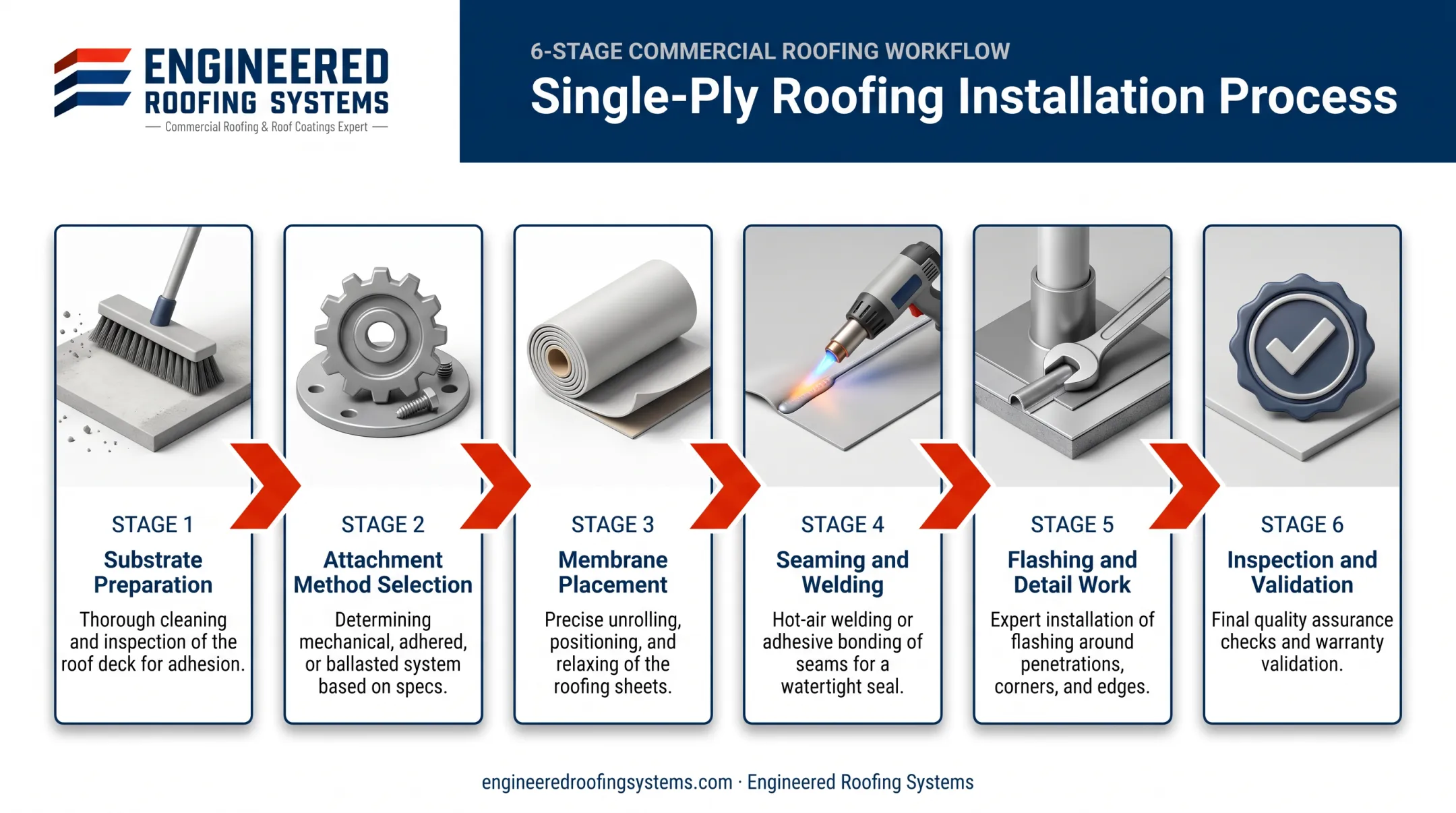

6-step single-ply roofing installation process flow diagram

For a typical commercial or industrial roof, expect several days to several weeks of work, depending on square footage, crew size, and weather.

Coordination matters as much as technique. Active facilities need installation sequenced around production schedules, not the other way around.

Prerequisites and Safety Considerations

Site and Substrate Readiness

The roof deck must be clean, dry, and free of blisters, holes, or scorched membrane sections before anything gets rolled out. Moisture trapped in the substrate is one of the leading causes of debonding and premature failure, so testing for hidden moisture isn't optional.

Common moisture-detection methods include:

  • Core sampling — physically checking roof-system conditions below the surface
  • Infrared scanning — identifying concealed moisture invisible to a standard visual inspection
  • Impedance or capacitance meters — mapping wet areas across the field without opening the roof

The National Roofing Contractors Association notes that moisture vapor can cause adhesive failure and delamination of both field and factory laps. Industry consensus is to remove wet insulation rather than try to vent it dry.

Compatibility and Code Checks

Before mobilization, confirm:

  • Membrane compatibility with existing insulation or cover board
  • Local wind-uplift and fire code requirements
  • Manufacturer specifications for the specific membrane product being used

Never install on wet substrates or during precipitation—no exceptions.

Crew Safety Essentials

Single-ply work on commercial and industrial roofs carries fall, heat, and material-handling risks. Lock these controls in before the first roll goes up:

  • Fall protection (harnesses, anchor points, and guardrails) on any elevated deck
  • PPE matched to the method: eye/hand protection, non-slip footwear, and heat-resistant gear for hot-air welding
  • Safe staging for membrane rolls, adhesives, and insulation so walk paths stay clear
  • Weather and heat monitoring—especially on dark membranes in full sun—with scheduled water and shade breaks
  • Hot-work and adhesive controls: extinguishers on hand, ventilation where solvents are used, and manufacturer flash-point limits followed

A dry, code-compliant deck only pays off if the crew finishes the day without an incident.

Choosing the Right Attachment Method

Attachment method is an engineering decision tied to deck type, wind exposure, and facility use.

Mechanically fastened systems are the most common choice. They're fast and economical, but they can billow in high-wind zones, and fasteners create thermal bridging points.

Fully adhered systems eliminate exposed fasteners and distribute wind uplift across the whole membrane rather than concentrating it at fastener points.

According to Carlisle's mechanically attached vs. fully adhered comparison, fully adhered assemblies typically produce superior wind-uplift results. They do require temperature-controlled application and more labor on concrete decks.

Induction-welded systems combine the speed of mechanical fastening with welded plates for more evenly distributed wind resistance. They're a middle-ground option worth considering on wind-exposed sites.

Ballasted systems use gravel or pavers to hold membrane and insulation in place. They're cost-effective and reduce labor, but the deck has to carry that extra weight, and these systems face restrictions in high-wind areas.

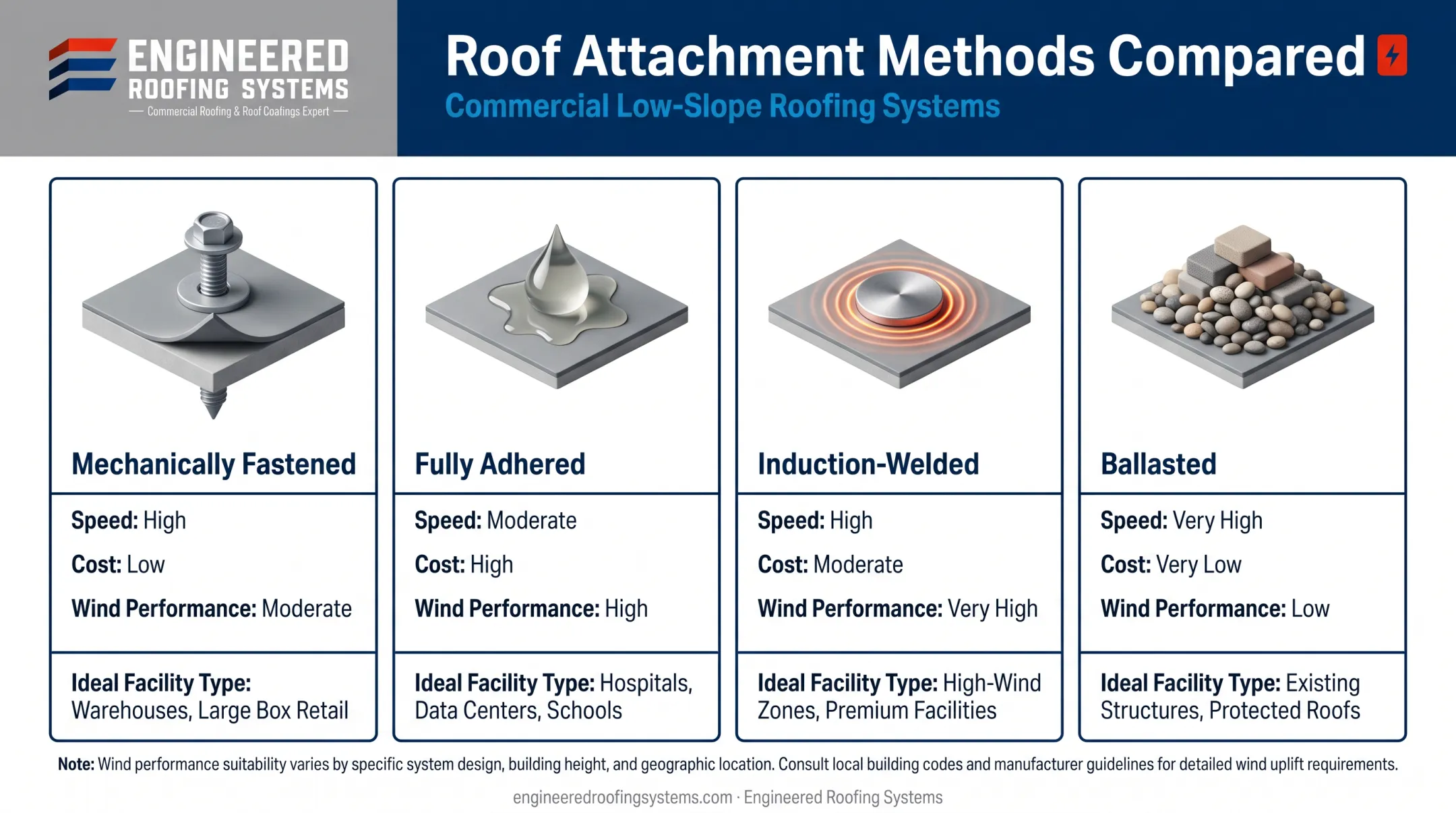

Comparison of four single-ply roof attachment methods and best uses

Facility type drives the decision:

  • Manufacturing plants with heavy equipment vibration often favor fully adhered or induction-welded systems
  • Warehouses with simple, open roof fields may work well with mechanically fastened or ballasted systems
  • Retail centers with numerous rooftop penetrations typically avoid ballast

Engineered Roofing Systems' technicians assess deck condition, building use, and wind exposure on-site before recommending a system — because the wrong attachment method on the right membrane still fails.

How to Install Single-Ply Roofing (Step-by-Step)

Skipping steps here, like rushing seam welds or eliminating a cover board, causes leaks that surface months later.

  1. Prepare the roof surface. Sweep debris, repair holes with non-shrink grout, and remove any scorched or damaged material from the existing deck.

  2. Lay insulation and cover boards. Select polyiso, EPS, or XPS based on required R-value and membrane compatibility. Layer boards as needed to meet climate-zone targets under ASHRAE 90.1-based codes (Versico commercial R-value guidance).

  3. Position and secure the membrane. Roll out TPO, PVC, or EPDM sheets according to manufacturer overlap specifications, then secure using the chosen attachment method.

  4. Seam and weld. TPO and PVC seams are hot-air welded; EPDM seams use adhesive or tape bonding. Weld width and temperature settings matter. A proper weld holds a consistent minimum width with no voids or wrinkles.

  5. Install flashing details. Seal perimeter edges, penetrations, and drains—the transition points where most leaks start.

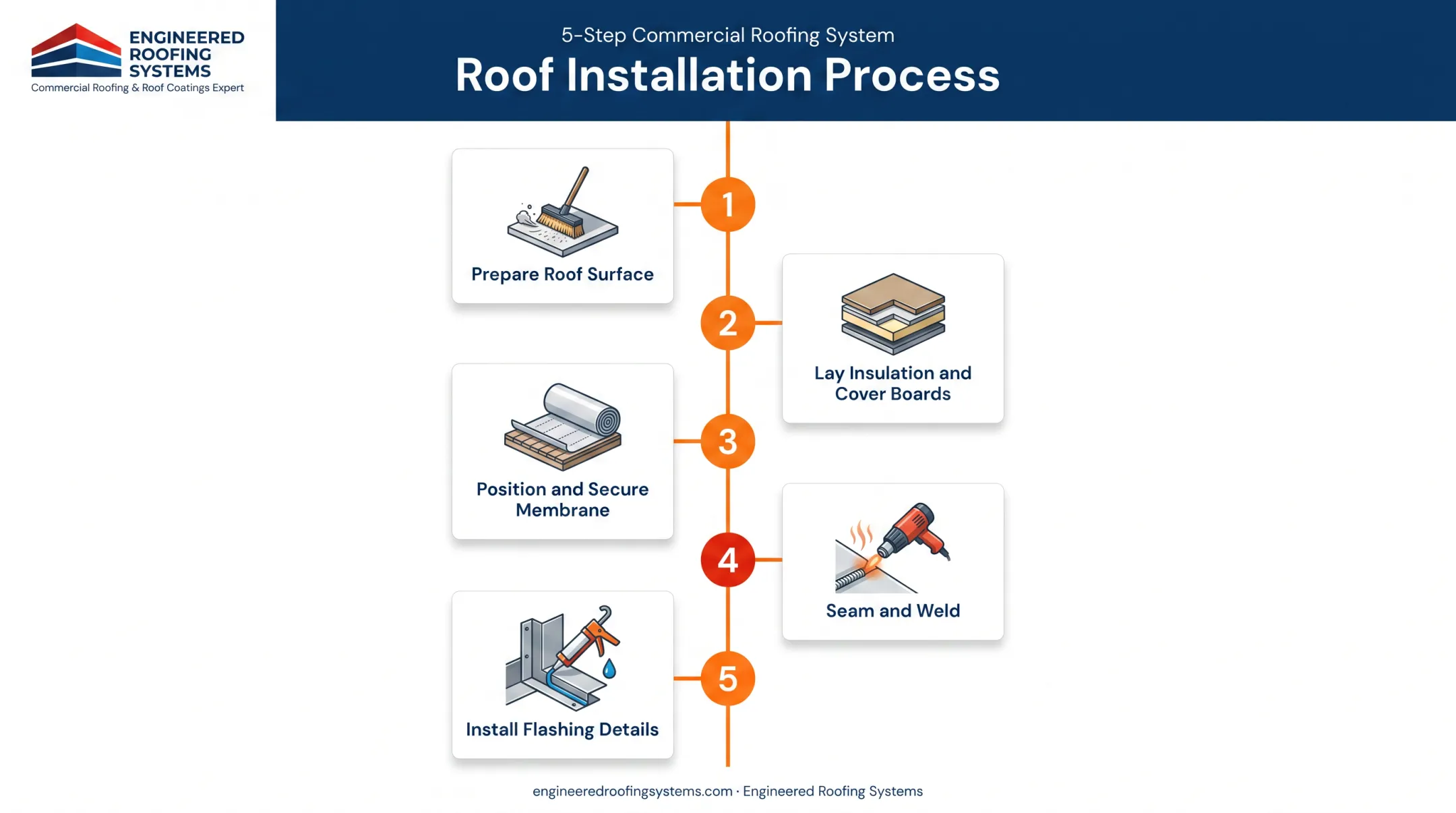

5-step single-ply membrane installation process from surface prep to flashing

Engineered Roofing Systems installs TPO and PVC as an authorized Versico, Carlisle, and Duro-Last contractor, with systems eligible for manufacturer warranties up to 30 years.

Post-Installation Checks and Validation

A roof that looks finished isn't necessarily a roof that's done right.

Visual inspection comes first: check for proper membrane lay, no wrinkles, and correct flashing termination at every edge and penetration.

Seam and T-joint testing comes next. Crews run a blunt probe along every seam to detect voids and check for a visible crease at T-joint intersections, which indicates a solid weld.

Carlisle's field guidance recommends probing every lap after seams cool, repairing any deficiency the same day, then re-probing the repair, according to Carlisle's seam probing and test weld guidance.

Skip probing and voids stay hidden until after warranty documentation is filed, which complicates any future claim.

Common Installation Problems and Fixes

Most single-ply failures start with installation, not the membrane. Here is how to spot and fix the issues crews see most often.

Seam Failures

Problem: Water penetration at membrane overlaps.

Cause: Incomplete welds, surface contamination before welding, or incorrect overlap width.

Fix: Cut out and re-weld with proper overlap, cleaning the membrane surface per manufacturer guidelines beforehand.

Membrane Billowing or Fluttering

Problem: Membrane lifts or flutters under wind load, especially in mechanically fastened systems.

Cause: Insufficient fastener density or a roof deck that is not airtight.

Fix: Increase fastener pattern per code, or switch to induction-welded or fully adhered attachment in high-wind zones.

Moisture-Related Debonding

Problem: Insulation or membrane separating from the substrate over time.

Cause: Trapped moisture in the substrate before installation began.

Fix: Conduct moisture surveys before installation and replace saturated insulation before re-covering.

Pro Tips for Installing Single-Ply Roofing Effectively

  • Follow manufacturer-specific guidelines. Overlap requirements and welding temperatures vary between TPO, PVC, and EPDM products — there's no universal setting.
  • Schedule around weather windows. Extreme cold requires warm, dry membrane storage and longer weld times; extreme heat can affect adhesive cure times.
  • Document everything. Seam testing and flashing inspections support warranty claims of up to 30 years, but only if the paperwork exists.
  • Hire experienced industrial contractors for active facilities. On live plants and warehouses, coordination matters as much as craftsmanship. Engineered Roofing Systems' authorized Versico, Carlisle, and Duro-Last crews have completed TPO retrofits at operating Southeast Texas facilities without full tear-offs.

Conclusion

Installation quality determines everything that follows: leak resistance, energy performance, and how long the roof actually lasts. There's no shortcut around thorough substrate prep, disciplined seam work, and proper flashing detail.

If your facility can't afford production downtime or a failed roof six months from now, choose a contractor who documents every step from prep through validation and can work around active operations. Engineered Roofing Systems has installed single-ply systems for industrial and commercial facilities across Southeast Texas since 2000.

Frequently Asked Questions

What are the key differences between single-ply and built-up roofing systems?

Single-ply uses one flexible membrane layer, while built-up roofing stacks multiple layers of asphalt and felt. Single-ply is lighter, faster to install, and easier to repair.

What is the best single-ply membrane?

It depends on climate and use case. PVC offers the longest lifespan and chemical resistance, TPO is cost-effective and energy efficient, and EPDM handles extreme temperature swings well.

Is single-ply the same as EPDM or TPO?

No. EPDM and TPO are specific types of single-ply membranes, alongside PVC. Each has different material properties and installation requirements.

Is single-ply roofing any good?

Yes. It's a reliable, widely used commercial roofing choice known for durability, reflectivity, and easy maintenance, provided it's installed correctly by trained professionals.

What does single-ply mean in roofing?

Single-ply refers to a roofing system installed as one continuous membrane layer over insulation and the roof deck, rather than multiple stacked layers.
